https://apps.apple.com/app/id1273600367
#london #drive #tfl #congestioncharge #ulez
London's cycleway scores on Friday 19 June'26, either side of 10pm:

- #CS3Count Victoria Embankment 8,570 cycle journeys today which seems low (others reporting on Bluesky that the totem frequently stalls), 600,469 since April reboot
- #CS6Count Blackfriars Road 6,220 today, 215,075 since reboot about 5 weeks ago
@CS3CS6Count
#Transport for #London Freedom of Information release:

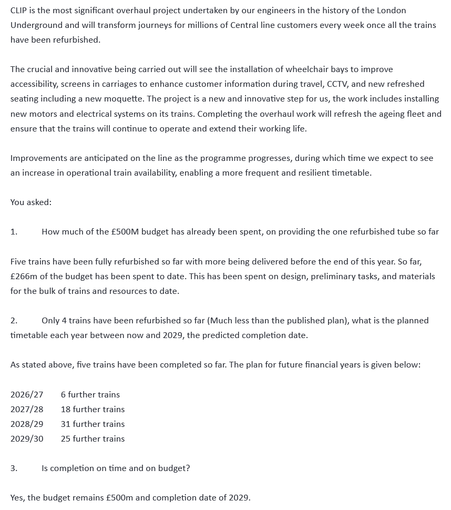

#TfL has confirmed that the Central Line Improvement Programme (CLIP) remains on time and within its £500 million budget, with completion scheduled for 2029. Responding to a freedom of information request, TfL disclosed that £266 million has been spent so far on design, preliminary tasks, resources and materials.
While the enquirer noted that few trains had been completed compared to published plans, TfL clarified that five refurbished trains are now in service. The innovative overhaul includes installing wheelchair bays, CCTV, new motors, electrical systems and refreshed seating to extend the ageing fleet's working life.
The remaining rollout timetable for the financial years between now and completion is structured as follows:
• 2026/27: 6 further trains
• 2027/28: 18 further trains
• 2028/29: 31 further trains
• 2029/30: 25 further trains
#Transport for #London Freedom of Information release:
#TfL has released rolling stock information sheets covering DLR B90-B23 trains. The documents confirm details of Bombardier-built B90, B92, B2K and B2007 vehicles, alongside newer CAF five-car trains. The two-car units use permanently coupled aluminium cars, operate in two- or three-car formations, and carry 56 seated passengers, one wheelchair user and up to 216 standing passengers. They feature VVVF propulsion, automated operation, passenger information systems and are maintained by Keolis Amey Docklands. The CAF fleet uses fixed five-car formations, offering 156 seats, five wheelchair spaces and up to 634 standing passengers, with updated doors, climate control and onboard technology. The B23 information sheet will be updated following a sanding system modification. 🚈
https://tfl.gov.uk/corporate/transparency/freedom-of-information/foi-request-detail?referenceId=FOI-0802-2627
#Transport for #London Freedom of Information release:
#TfL confirmed it holds information relating to compensation payments connected to the Gallows Corner Works. The response addressed whether Costain had been instructed to pay any businesses compensation beyond the two known closures, Wax On and Gallows Corner Motors.
TfL said major works were completed in April 2026, while Essex & Suffolk Water continued repairs after identifying issues during testing of a new water main. Some roads have reopened, including the eastbound flyover, Straight Road and Main Road, while westbound restrictions remain until water works finish. TfL said coordinating the projects aimed to reduce future disruption and thanked residents and businesses for their patience.
https://tfl.gov.uk/corporate/transparency/freedom-of-information/foi-request-detail?referenceId=FOI-0562-2627
#Transport for #London Freedom of Information release:

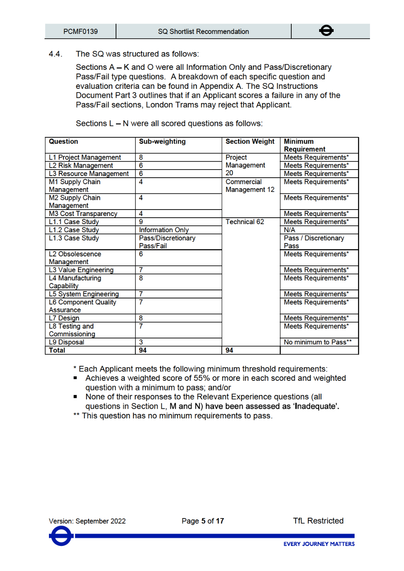

#TfL has published a redacted report on the procurement of 24 new #Croydon Tramlink trams. Six manufacturers took part in the pre-qualification process, with five meeting the required standards and progressing to the tender stage.
The £385 million contract covers the supply of new #trams, technical support and spare parts. Bids were assessed against financial, technical, quality, safety, cyber security and operational requirements.
One bidder was disqualified after failing to meet several criteria, while the remaining five were shortlisted. The supplier selection report was approved in July 2024.
https://tfl.gov.uk/corporate/transparency/freedom-of-information/foi-request-detail?referenceId=FOI-0283-2627
