Construction update: first delays of the project!

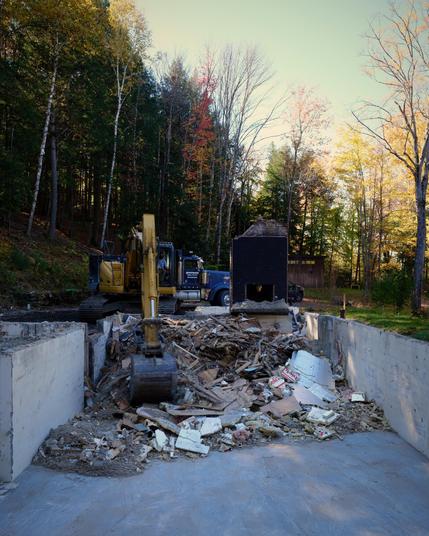

- Because of linemen going to help with hurricane recovery down south, it has taken three weeks to get power disconnected from the existing structure. So the excavator is just siting in the driveway waiting. Supposedly it will be disconnected today.
- Because of the threat of the dock workers strike, our windows were not loaded onto a ship from Germany on Sept 27 like they were supposed to be. As far as we can tell they're still waiting in port in Hamburg right now.

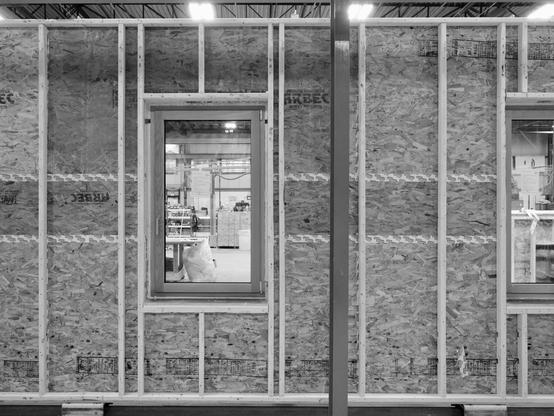

Best case scenario, we're running about a month behind schedule now. Windows are on the critical path. Transit -> wall fabrication -> delivery to site -> raising -> roofing.

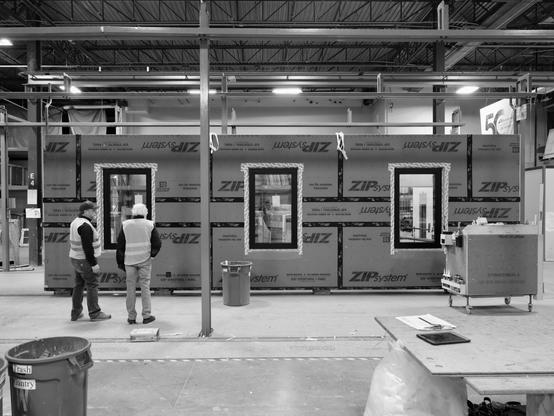

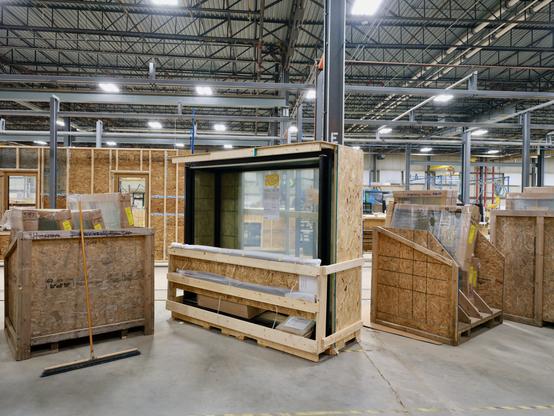

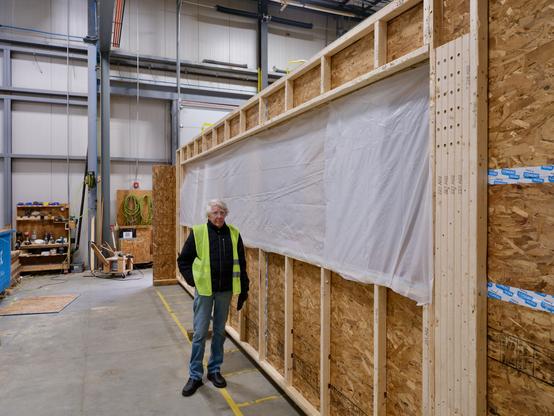

Schedule update: they never found the windows in Germany, but we did find them on a boat in the Atlantic. They are due to arrive in NYC the beginning of next week, which means we can hopefully begin fabricating walls the first week of November.
